Gather installed-drive data safely
A purchase order should preserve an approved replacement or define a fully reviewed redesign. A familiar code, matching top width, equipment name, low price, or supplier assurance cannot establish fit, power capacity, environment compatibility, or regulatory status. The buyer needs one traceable specification that connects the real drive to the exact product family and the evidence required at release and receipt.
Start with the installed drive and approved design
For an approved like-for-like replacement, capture the complete readable marking, manufacturer, product family, profile, construction, length designation and basis, quantity or matched-set rule, and the machine or OEM reference. If any element is missing or the proposed source differs, treat the order as an engineering review rather than assuming interchangeability from width or a similar code.
For a redesign, record driver and driven equipment, actual power or torque, shaft speeds, starting method and torque, hours, shock or pulsation, sheave datum or pitch diameters, ratio, center distance, wrap, idlers, take-up, guard space, environment, and required approvals. Select the family and belt count only through the current manufacturer diagram, service factor, rating and correction tables, minimum-sheave and speed limits, shaft-load check, and tension procedure.
Build one procurement specification
Procurement specification and evidence matrix
Each row is a separate release requirement. A catalog family name does not prove the other rows.
| Requirement | Evidence to send with the request | Release criterion |
|---|---|---|
| Installed identity or approved design | Photograph or transcription of the full marking, OEM part reference, drive drawing and revision | Exact approved replacement, or documented engineering approval for a change |
| Profile and construction | Manufacturer, product family, section, wrapped or raw-edge sidewalls, smooth or molded-notch underside, single or joined assembly | Belt, grooves, guarding, minimum diameter and ratings are compatible |

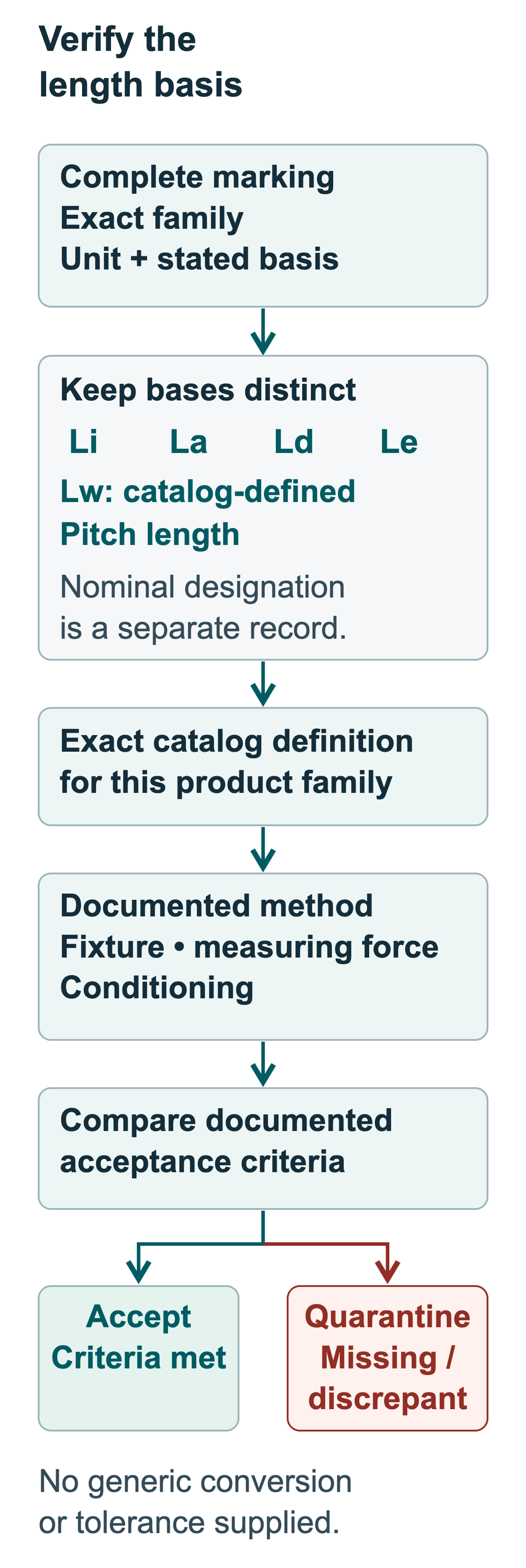

| Length system | Full designation, nominal value, unit and basis such as Li, Lw/Ld, Le, La or the maker-specific equivalent | Exact catalog row and tolerance identified; no generic circumference conversion |
| Duty and geometry | Power or torque, speeds, start, hours, shock, sheaves, ratio, center distance, wrap, idlers and take-up | Current maker calculation supports family, count, length, shaft load and tension |
| Materials and environment | Body, cord and cover specification plus temperature, water, oil, chemical, ozone, weather and flame needs | Exact series datasheet and compatibility statement cover the actual exposure |
| Multiple-belt set | Quantity, maker matching rule and any set or match code | Complete compatible set; no mixed used/new belts or manufacturers |
| Standards and regulated use | Applicable clause, exact product-family certificate or declaration, revision, issuer and validity | Document scope matches the ordered family, market and intended use |
| Delivery and traceability | Approved source, part revision, packaging, identification, change notification, certificate lot linkage and delivery plan | Supplier can preserve identity and report any change before shipment |
- Evidence to send with the request
- Photograph or transcription of the full marking, OEM part reference, drive drawing and revision
- Release criterion
- Exact approved replacement, or documented engineering approval for a change
- Evidence to send with the request
- Manufacturer, product family, section, wrapped or raw-edge sidewalls, smooth or molded-notch underside, single or joined assembly
- Release criterion
- Belt, grooves, guarding, minimum diameter and ratings are compatible
- Evidence to send with the request
- Full designation, nominal value, unit and basis such as Li, Lw/Ld, Le, La or the maker-specific equivalent
- Release criterion
- Exact catalog row and tolerance identified; no generic circumference conversion
- Evidence to send with the request
- Power or torque, speeds, start, hours, shock, sheaves, ratio, center distance, wrap, idlers and take-up
- Release criterion
- Current maker calculation supports family, count, length, shaft load and tension
- Evidence to send with the request
- Body, cord and cover specification plus temperature, water, oil, chemical, ozone, weather and flame needs
- Release criterion
- Exact series datasheet and compatibility statement cover the actual exposure
- Evidence to send with the request
- Quantity, maker matching rule and any set or match code
- Release criterion
- Complete compatible set; no mixed used/new belts or manufacturers
- Evidence to send with the request
- Applicable clause, exact product-family certificate or declaration, revision, issuer and validity
- Release criterion
- Document scope matches the ordered family, market and intended use
- Evidence to send with the request
- Approved source, part revision, packaging, identification, change notification, certificate lot linkage and delivery plan
- Release criterion
- Supplier can preserve identity and report any change before shipment
Source: Gates Preventive Maintenance Manual and Heavy-Duty V-Belt Drive Design Manual; Optibelt Technical Manual; ISO 4184:2025; ISO 1081:2013
Verify standards and regulated-use evidence
Use each standard only for its published scope. ISO 4184:2025 addresses specified classical and narrow V-belt dimensions and datum-system lengths; ISO 1081:2013 supplies belt-drive terminology. ISO 1813:2014 defines an antistatic-conductivity test and limits, so request evidence for the exact family and, where the maker qualifies it, its condition when new; also verify conductive contact, sheaves, earthing, and independent hazardous-area controls. ARPM IP-20 applies to drives using classical A, B, C and D belts and sheaves, not every industrial belt or its oil and chemical resistance.
CE marking applies only when specific EU product legislation requires it; the CE mark on a machine does not automatically create a CE-marking requirement or approval for a replacement belt. ISO 9001 and IATF 16949 are quality-management-system evidence within their certified scope, not proof that a belt has the required dimensions, capacity, compound, conductivity, flame behavior, or legal status. Ask for the product evidence actually required by the market and application.
Qualify the supplier and change-control path
Qualify the source by capability, not geography or catalog breadth. The supplier should identify the manufacturer and exact family, provide current controlled datasheets and rating or tension instructions, link certificates to the delivered product, preserve traceability, manage nonconforming product, and name a responsible technical contact. For critical or unfamiliar parts, define sample, first-article, dimensional, or application review before volume release.
Require advance notice and approval for changes to manufacturer, plant, family, materials, construction, dimensions, marking, matching method, certification, tooling, or process where they affect the specification. Define substitution authority, deviation handling, record retention, corrective action, and stop-ship rules. A seller saying “equivalent” is not change approval.

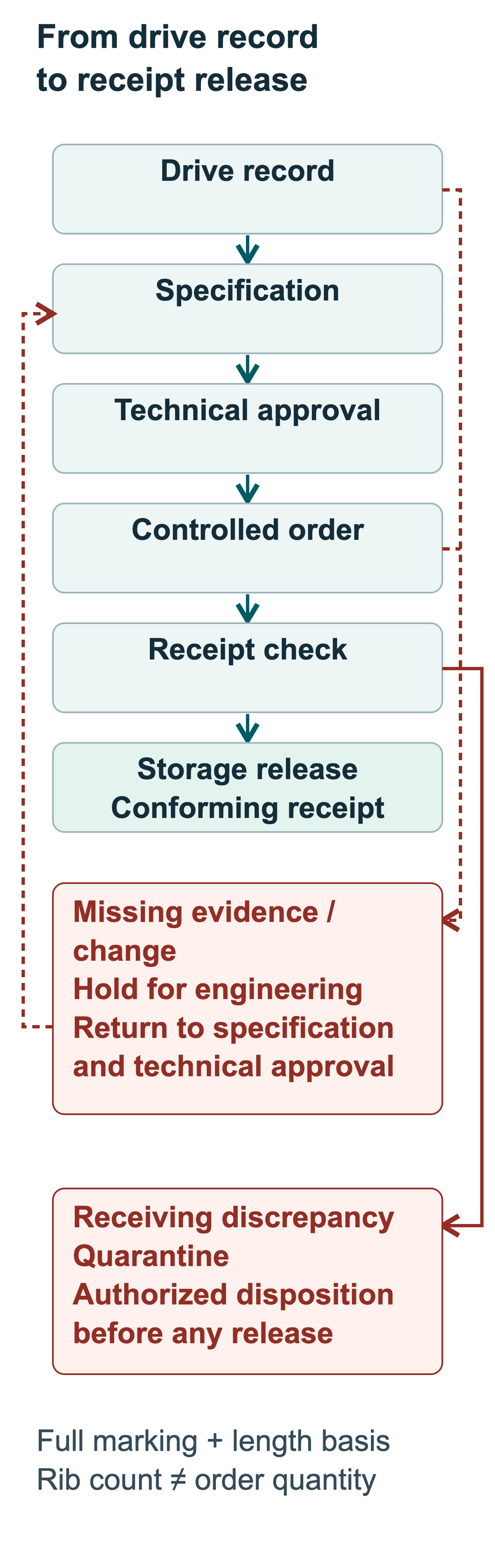

Release the purchase in a controlled sequence
Use this release sequence for each belt or matched set:
- Identify the asset, approved drawing or OEM part, installed marking, supplier history, failure consequence, and authorized technical owner.
- Decide whether the request is an exact replacement, an approved alternative, or a redesign; route alternatives and missing data to engineering.
- Complete the duty, geometry, environment, safety and regulated-use inputs before choosing a family or requesting a quotation.
- State manufacturer, exact family, profile, construction, length value and basis, quantity, matching rule, materials, marking, and packaging.
- Attach the current maker selection or rating evidence, correction factors, minimum-sheave and speed checks, shaft-load result, and tension instructions when design approval is required.
- List each certificate, declaration, test report, inspection record and source revision required at quotation, order release, and delivery.
- Evaluate technical compliance separately from price, lead time, minimum quantity, logistics, spare strategy, and total lifecycle risk.
- Approve the supplier and purchase order under document control; record deviations and prevent unapproved substitutions or changes.
Require an auditable purchase record
The purchase order or controlled attachment should identify:
- Asset, machine, drive drawing, OEM or engineering approval reference, revision, buyer and technical approver.
- Manufacturer, exact product family, full marking, profile, construction, materials and product revision.
- Nominal length, unit, length basis, catalog reference, tolerance, quantity and matched-set or set-code requirement.
- Duty and geometry used for selection, including power or torque, speeds, service factor, sheaves, wrap, center distance and corrections.
- Environment and compliance requirements with exact certificate, declaration, test method, issuer, revision, scope and validity.
- Approved manufacturing source, distributor, traceability fields, marking, packaging, preservation and change-notification requirement.
- Required quotation review, sample or first-article approval, receiving inspection, nonconformance route and record-retention period.
- Commercial terms kept separate from technical acceptance: quantity, delivery, lead-time risk, warranty, spare rationale and lifecycle cost.
Inspect receipt, storage, and installation readiness
At receipt, compare the shipment with the controlled order: manufacturer and source, full marking, family, profile, length and basis, quantity or complete matched set, set or lot code where required, certificates, packaging, and visible condition. Use an approved sampling and measurement plan for critical dimensions; do not kink, sharply reverse-bend, or damage a belt during inspection. Quarantine any discrepancy, substitution, missing evidence, contamination, deformation, or damage until disposition is authorized.
Record receipt date and traceability, then store to the exact manufacturer limits and ISO 2230:2026 rubber-product framework, controlling distortion, heat, light, ozone sources, solvents, chemicals, humidity, and minimum bend diameter. Spare quantity is a risk decision based on criticality, lead time, shared usage, documented storage life, failure history and inventory cost—not a universal extra set. Before installation, confirm sheave condition and alignment, exact belt/set identity, manufacturer tension and run-in instructions, safe-work procedure, and guard readiness.
A defensible belt purchase is a controlled engineering record. It identifies the real drive, the exact product and length system, the evidence that supports performance and compliance, the supplier’s change obligations, and the checks that release the shipment for storage and installation. If one of those links is missing, the order is not yet technically complete.
Key Takeaway
What information is required to buy the correct industrial V-belt?
Specify the asset and approved design, manufacturer and exact family, profile and construction, length value and basis, quantity or matching rule, duty and sheave geometry, materials and environment, required product evidence, supplier traceability, and receiving criteria.
Need a traceable quotation review? See the classical V-belt range and SP power belt range, or contact SQUAREROPE with the full marking, drive data, environment, quantity, and required documents.
